WAIKŌWHAI PROGRESS UPDATE: QUARTER 2, 2026

14 Jul 2026
J002535 Waikowhai Progress Update DEC Blog header 1600x800px 1IT

HOW WAIKŌWHAI IS TAKING SHAPE

Waikōwhai is part of the wider Roskill Development, led by Kāinga Ora – Homes and Communities, focused on delivering new homes alongside upgrades to parks and essential infrastructure.

When complete, the Waikōwhai neighbourhood will deliver over 700 brand-new homes.

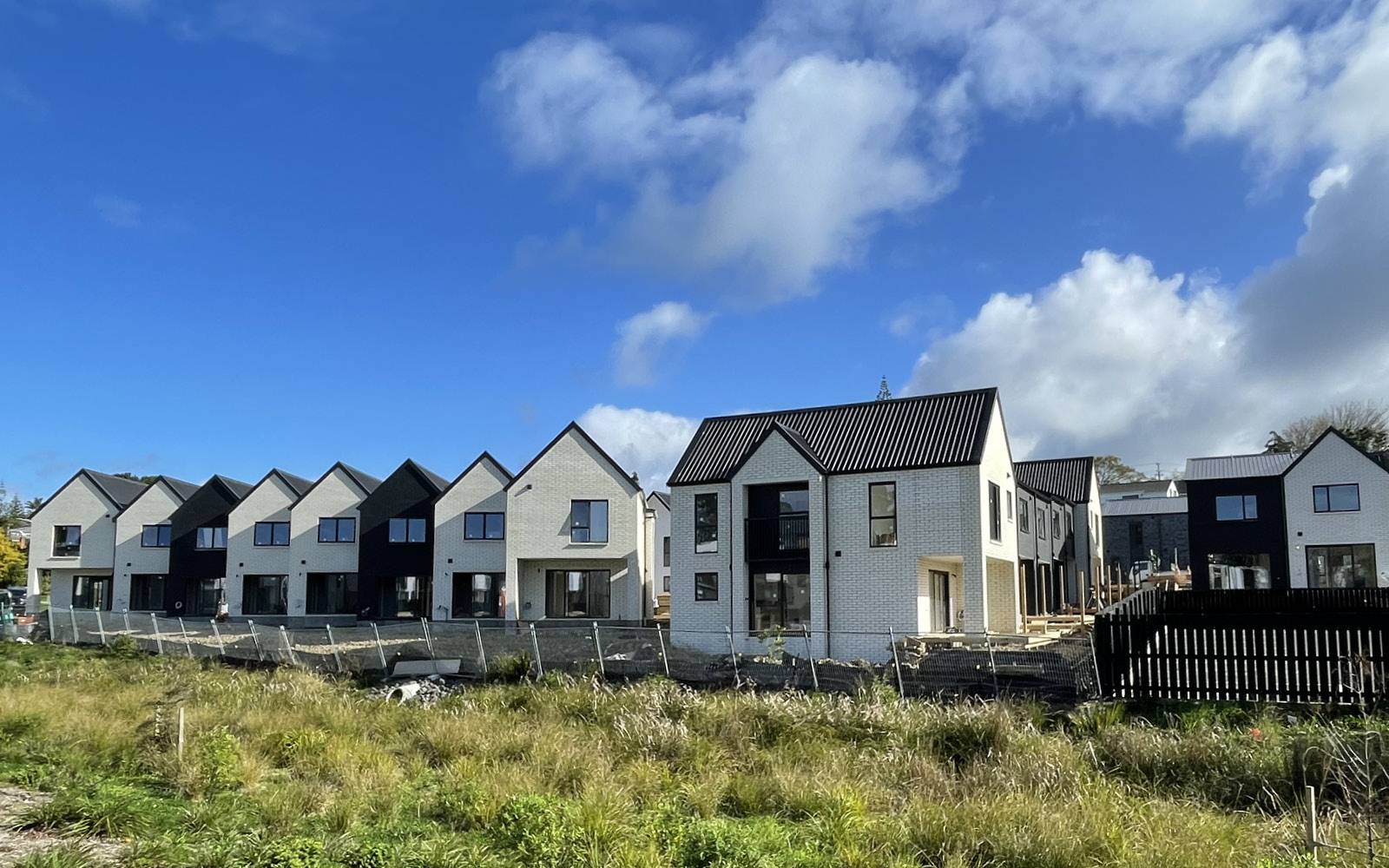

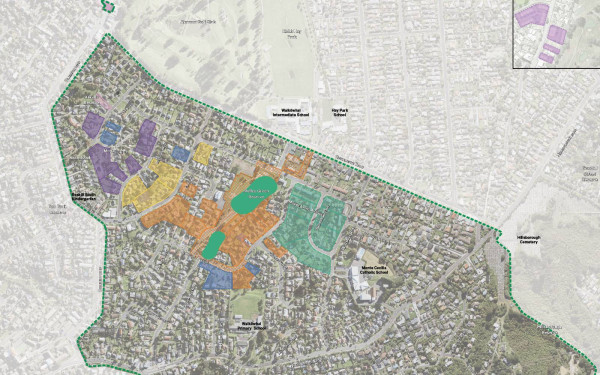

WHERE STAGES 1 AND 2 STAND

Physical works for Stages 1 and 2 are now almost complete, enabling around 380 new homes. This includes 22 social homes, now complete. All market land across these stages is fully contracted, with seven development partners.

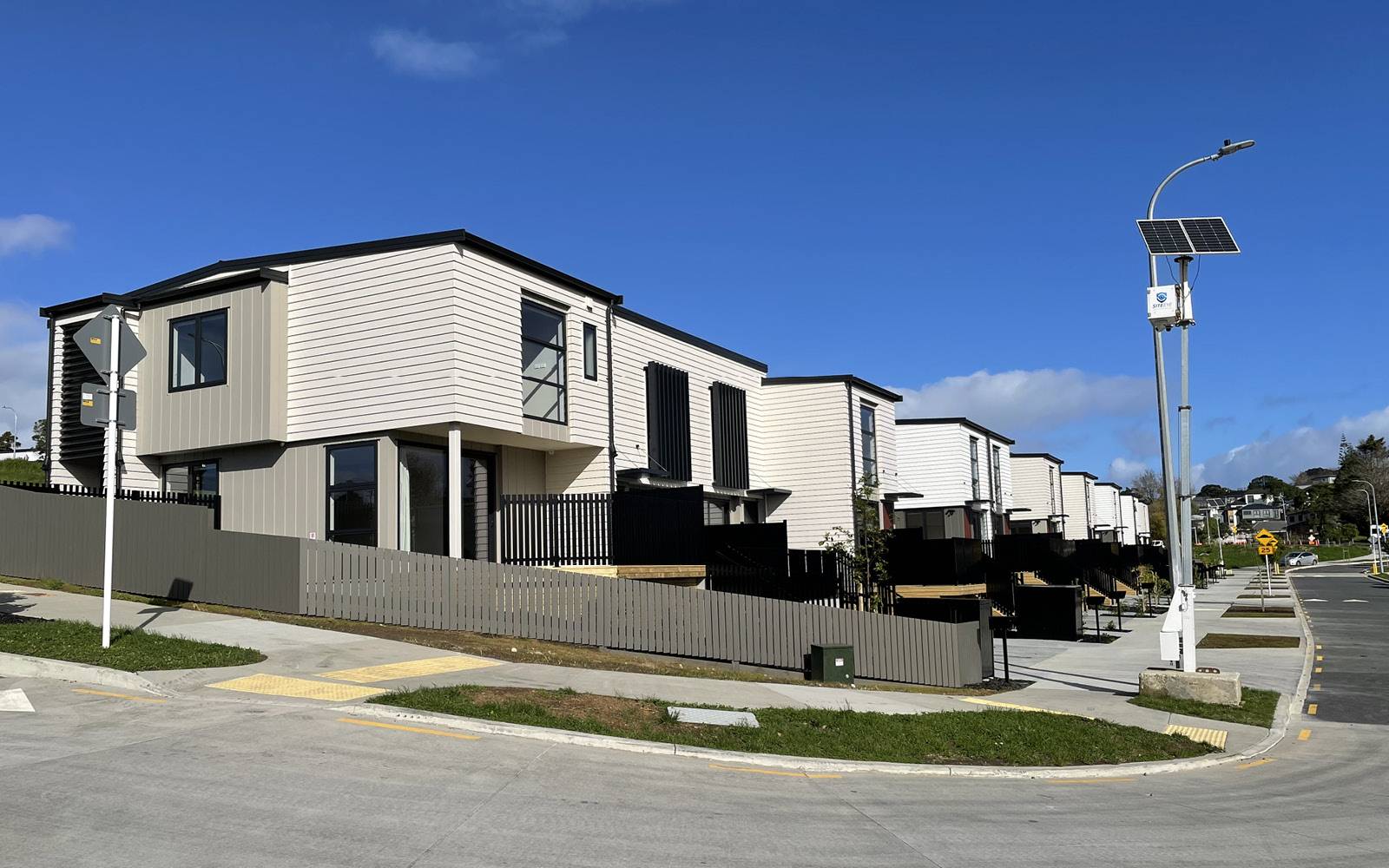

FIRST MARKET HOMES COMPLETE

House construction is in its final stages for the first two market superlots, yielding 43 homes. These homes are currently available to purchase, with many more market homes due to commence construction later this year and also become available to buy.


GREEN SPACES AND THE AWA

The Molley Green Reserve upgrade is now complete, with the reserve fully open to the community.

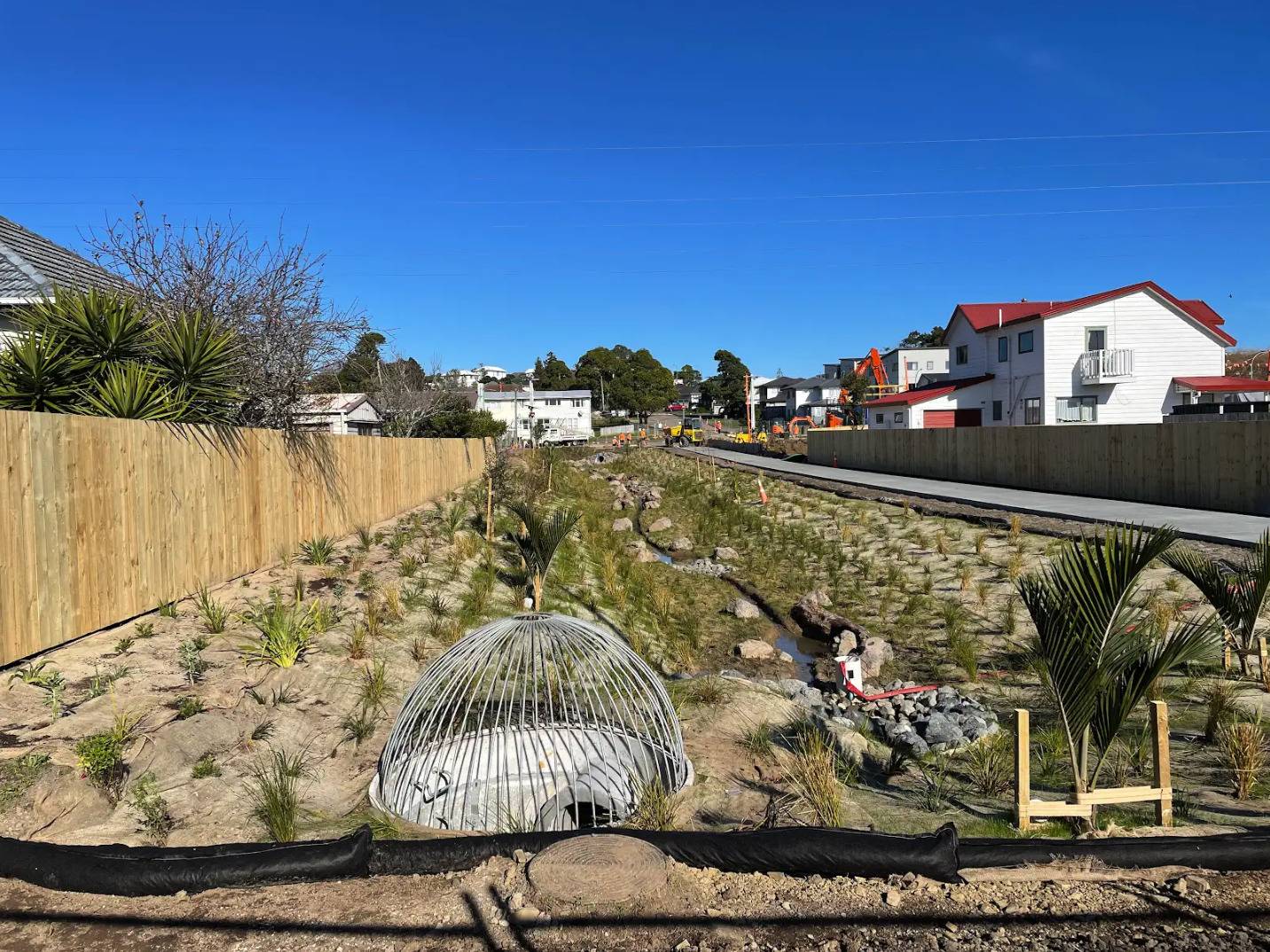

Work continues to progress well on Te Auaunga ki Tai Reserve, an extension of Molley Green Reserve. Wastewater and stormwater works are complete, flushing of the stream channel is complete, and planting has now commenced. The project delivers critical stormwater and wastewater upgrades, alongside the ongoing daylighting of the awa, with completion anticipated around August 2026.




GETTING READY FOR STAGES 4 AND 4B

Resource consents and engineering approvals have been granted for Stage 4 and 4B. House removals have commenced, to be followed by civil construction — enabling approximately 145 social homes and around 100 market homes.  Civil construction will commence around November 2026 and complete around August 2027.  Social house construction is expected to get underway shortly after.

WHAT'S NEXT FOR WAIKŌWHAI

Waikōwhai continues to move forward as a well-connected, future-ready neighbourhood, with homes, parks and infrastructure taking shape together. Thank you to all in the community who have shared their time and input.


TIMELINE

Winter 2026

  • First 43 market homes completed and available to purchase.

  • More market homes to commence construction and available to purchase.

  • Stage 4 and 4B house removals commence.

Spring 2026

  • Te Auaunga ki Tai Reserve works complete.

  • Stage 4 and 4B civil works commence.

  • More market homes completed.

Summer 2026/2027

  • More market homes to commence construction.

  • Stage 4 and 4B civil works continue.


TOTAL HOMES (by stage)

NEW HOMES TOTAL HOMES COMPLETED TO DATE
SOCIAL 151 22
MARKET 536 43
TOTAL 687 65

*Approximate numbers only. We will provide updates if there are any changes to the plans.


HOMES FOR SALE

From first homes to forever homes – there are all sorts of beautiful, brand new, high-quality houses for sale in Roskill Development. See all of the homes for sale right now, right here.

WANT TO KNOW MORE?

Click here to learn more about Waikōwhai or get in touch. Or pop in for an in-person chat with one of the team. Roskill Development has an information centre at 142 May Road, Roskill South, which is open Wednesday to Saturday between 10am – 4pm. Walk-ins welcome, or you can make a booking.
